Project Update - Moree Artesian Aquatic Centre (MAAC)
This week, works have continued across both the Active and Passive Pools at the MAAC.

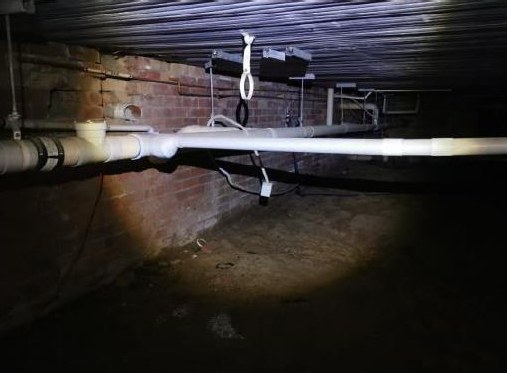

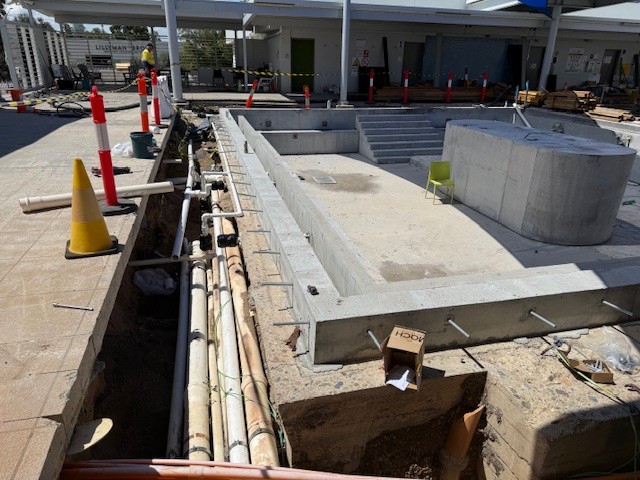

At the Active Pool, extensive piping and electrical conduit installations are underway around the pool perimeter, with preparations being finalised for upcoming concrete works over the piping and conduit. The construction of a shade structure is underway. This structure will assist in managing temperature impacts on the concrete by reducing direct sunlight exposure during the curing process.

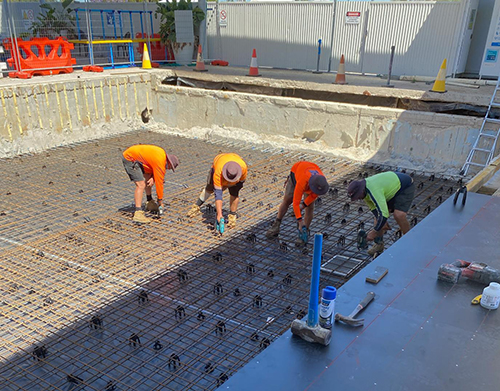

Over at the Passive Pool, a new concrete pour has also been completed on the pool steps and seating.
Published: Friday, 14 November 2025 01:34
Many community members want to better understand the present state of play, what's currently happening at the Moree Artesian Aquatic Centre (MAAC), and why Council is looking at an alternative option for development of the 50-metre pool at Taylor Oval.
This page has been set up to keep you in the loop.
Since 2020, the Moree Plains community has unfortunately lacked a 50m pool, meaning many children have been unable to participate in swimming lessons. Council has responded to the initial issues that led to the demolition of the 50m pool, but additional issues – in particular, leaks – continue to be discovered at the MAAC.
Despite a lot of work to address leaks and other failing infrastructure, there's no guarantee that more leaks won't occur.
There is no perfect answer, but waiting another five years for a pool is not an option. So Council is looking to progress the best available solution.
To stay abreast of future updates, bookmark this page and stay tuned to Council's Facebook.
The history of the MAAC provides context for some of the current issues.
1913 – the original six-lane, 60-yard pool was built.
1965 – the Freedom Ride and protests occurred at the MAAC in February 1965, leading to a National Heritage Listing.
1977 – facility improvements, with the addition of some of the brick buildings and amenity facilities, as well as the two open-air hot pools.
2011 – extensive redevelopment of the facility, with the demolition of all existing pools to develop:
a new eight-lane, 50m outdoor pool.
the program pool.
the children's splash area.
the installation of new water filtration systems.
the construction of two new hot spa pools.
the conversion of the eastern wing and the enclosed hot artesian pool into the gymnasium, café, and administration offices.
the conversion of the western wing and the reconfiguration of the enclosed artesian pool into the Wellness Centre.
construction of the water slide.
2012 – issues and defects with the redeveloped MAAC emerge.
2020 – the 2011 50m pool was decommissioned and eventually demolished due to structural failure.
2023-24 – The program and wellness pools were refurbished and the splash park was removed due to water leaks.
2024 – construction of a new 50m pool, grandstand and associated earthworks commence, with a review of environmental factors.
2025 – refurbishment of the passive and active hot pools.
Other critical issues at the MAAC
Incorrect pipe sizes and fittings have been applied – both by trying to fit incorrect sized pipes to existing pipes, as well as the use of pipes and other infrastructure that didn't meet required standards.
The plant was due to be replaced in 2016, but continued to operate, resulting in failures that saw SafeWork NSW close the facility in January 2025 to address issues with pumps and pipelines for the transfer of chlorine and hydrochloric acid, leading to the installation of a new chlorine storage tank.
General deterioration of the facility’s equipment, including switchboards, controllers, and pumps that have passed their functional service life.
Failed sand filters, hot water systems and showers as recently as July 2025.
The closure of the program pool in December 2024 due to a filter failure.
Overall failure to adhere to the asset maintenance and replacement schedules, contributing to resourcing and budgetary constraints.
Leaks
Multiple pools, buildings and facilities leak, with investigations resulting in further leaks being found.

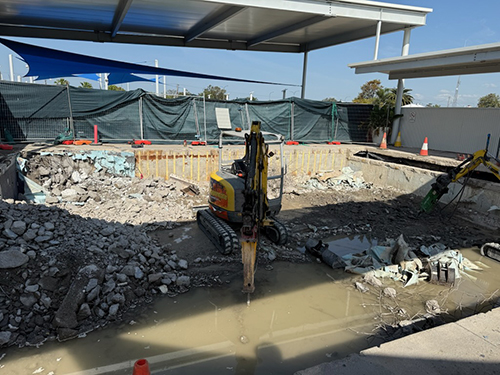

Earthworks for the new 50m pool commenced in March 2024, but were halted shortly after excavation commenced, as the contractor thought they'd hit an underground spring due to the volume of water found. Analysis showed it to be artesian water, which highlighted that the leakage is from the MAAC. The presence of this water meant earthworks had to halt.
The artesian leaks contributed to toilet, change rooms, pipe work and fitting failures (although some of this is also associated with movement of the existing buildings). This has caused waterproofing of amenities to fail, contributing to leaking under the buildings housing those facilities.
The 2011 active and passive hot pools were built inside the shell of the 1913 pool, having retained the concrete slab underneath, with topping slab poured that has since been found to be of poor quality. This contributed to a substantial amount of the leakage, however this was not evident until these pools were demolished. Both the active and passive hot pools are in the process of being rebuilt.
The newly constructed Wellness Centre was also leaking water, undermining its foundations.
Further leak detection undertaken in early 2025 found the decommissioned children’s splash area had been leaking water for three years because one of the pipes servicing it had not been capped properly.

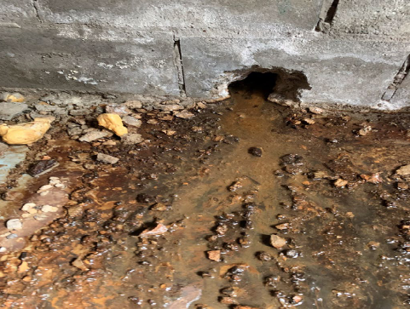

As of August 2025, an active leak continues underneath the MAAC, which is apparent around the splash pad area.
One of the ongoing risks is ground movement, contributed to by leaks under the buildings, leading to a need to reroute drainage.
A heavy storm event in 2024 presented roof leaks, the roof having bowed due to the weight of the solar panels installed.
Council has engaged plumbing services to investigate, a process which sees each element investigated one by one to eliminate them as a source of leak. Complicating this task is an absence of accurate drawings from the 2011 redevelopment – a result of both poor filing and staff turnover.
Leak investigations have also been delayed due to the need to undertake maintenance work on hot-water systems, wet areas, change rooms, as well as pumps and other facilities.
Addressing these issues Roejen Engineering Services provided Council with an asset condition report in December 2024.
Grant money for the project is specifically for a 50m pool, grandstand and tiered seating, the result of the following generous grant funds:
Approximately $10 million from the Australian government.
Approximately $8 million from the NSW government.
Approximately $5 million from Council.
Some of this amount has been spent on work at the MAAC, while most of the rest is approaching expiry, so Council will submit variation requests to the relevant government agencies to extend this funding.
Financial considerations for a new site
With the construction of a new 50m pool expected to cost tens of millions of dollars, and considering the length of time spent already to try and progress works at the MAAC, the ongoing difficulty of locating leaks and the costs to fix the issues, Council has resolved to consider an alternative site that provides some cost preservation and value for public money.
The new site needs to be:
Owned by Council, so additional funding to purchase one (which cannot be covered by grant funds) is not required.
Flood free, because building a pool at risk of frequent flooding requires additional construction, which elevates costs.
Zoned appropriately and offers sufficient space for current and future needs, as well as being located close to the schools who would benefit from its use for both school carnivals and learn to swim programs.
Taylor Oval meets all these considerations.
Why Taylor Oval?
Taylor Oval is a recreation sporting precinct, with existing tennis facilities, so installing with the 50m pool is consistent with the historical use of the precinct. Further, a pool at Taylor Oval will bring both locals and tourists to the town centre, contributing to the redevelopment of Balo St.
From a financial perspective, a pool at Taylor Oval helps contain the costs.
The first time Council went to market, the only tenders received were from companies that had not built a pool before, making these tenders unacceptable.
Going back to market to call for new tenders, not one builder wanted to take on the whole project – they wanted it split up:
Earthworks and piling as one project and contract
Building the pool as a separate project and contract
Concreting to be another project and contract
That's not normally what happens when you go out to market for a pool and was due in large part to the complexities of the MAAC site and the constraints of having to work around residential building.
These complexities do not make for a particularly appealing business proposition, so Council had less competition for the job – and less competition can often mean paying a higher price.
As a greenfield site where contractors do not need to work around existing infrastructure, Taylor Oval presents as a more attractive project, leading to greater competition.
History of Taylor Oval
1892 – first officially designated a sporting precinct, leading to the site becoming the pre-eminent Oval within Moree.
2005 – Council adopted a Sports Facilities Strategy, as a result of a report by Thompson Tregear that found Taylor Oval did not meet the requirements of a premium sports facility, seeing a shift towards Ron Harborne Oval.
2007 - Taylor Oval was entered as a burial site on the Aboriginal Heritage Information Management System (AHIMS).
2011 – Taylor Oval is listed as a place of Aboriginal cultural significance in Moree Local Environmental Plan.
2011 – the State Government supported a change in the zoning of Taylor Oval from a recreation zone to a commercial zone (redeveloped as an aquatic facility is a permissible use both in a commercial and a recreation zone).
Feasibility of Taylor Oval
Council engaged NSW Public Works on 21 March 2025 to undertake a feasibility study into the construction of a facility at Taylor Oval containing:
50 m pool.
Covered grandstand and 2 x 10 m covered seating areas.
Two-storey amenities building including change rooms, amenities, storage area and club room with deck.
Plant room and plant equipment.
Service desk and entry foyer.
Security fencing with access control.
Concreted pool surrounds and pathways.
Car park for up to 30 vehicles.
The study found: “Taylor Oval is a suitable location for the proposed new pool given its connectivity to the town centre, its proximity to the existing sporting and community infrastructure and the local schools. It also affirms that construction is feasible, pending the completion of the design and engineering phases, including further detailed site investigations.”
The Aboriginal Heritage Information Managament System (AHIMS) listing
As per the Heritage NSW feasibility study, extensive work has already been undertaken in regards to Taylor Oval’s heritage, such as: “historical research including parish maps, oral histories, electro-magnetic subsurface imaging and a substantive program of subsurface test trenches”, which led to the conclusion, “it seems unlikely that Taylor Oval… was a specific location used as a traditional Aboriginal burial ground”.
As per the recommendation of NSW Public Works, Council has requested that Heritage NSW reviews the AHIMS listing in light of prior findings.
What has Council resolved to do?
The feasibility report prepared by Department of Public Works NSW was presented to Council at the Ordinary Council Meeting on 17 July 2025.
The report had the following scenarios:
Scenario 1: If Heritage NSW approves Council's request for the review of the Taylor Oval site listing – a process that generally takes 60 days – a report will be brought to Council to consider concept options for construction and seeking endorsement for undertaking grant funding variation request to complete the project.
Scenario 2: If Heritage NSW denies the request, a detailed archaeological investigation of Taylor Oval will be required. This is expected to take at least 40 weeks, during which time there be no construction occurring at Taylor Oval.
Council resolved to note the report for information and proceed with Scenario 1.
Concept site plans prepared by public works
These are early plans – not final designs – that illustrate how a 50m pool could sit on Taylor Oval.
Next steps
Pending advice from Heritage NSW, Council will progress project planning for the 50m at Taylor Oval, including consultation with the community with regard to:
The short term concept and detailed designs for the site, including exactly what infrastructure is proposed to be built at Taylor Oval and how other uses for the site can be incorporated (such as car-parking, SES operations during flood events, green space and acknowledgement of cultural/historical significance);
The long term master plan for the site;
Investigation into the artesian water connection at the site.
Project Update - Moree Artesian Aquatic Centre (MAAC)
Program Pool Update We’re excited to share that the Program Pool has been refilled and is currently undergoing manual chlorine dosing to meet the required water quality standards and further cleaning.
We expect to reopen the Program Pool next week. As soon as we have a date, we will let the community know.
Published: Tuesday, 11 November 2025 17:10
Project Update - Moree Artesian Aquatic Centre (MAAC)
Passive Pool A further update on the remediation works at the MAAC, today saw the concrete slab poured in the Passive Pool. Once stabilised, the concrete will take a further 28 days to cure and set. Active Pool Plumbing works continue in the Active Pool with durable, fit-for-purpose poly piping. Program Pool Since the implementation of the new filters, work on emptying approximately 118,00 litres of water from the Program Pool is being undertaken.
The pool will be refilled tomorrow, with the balance tank cleaned out. Once thorough testing has been completed, we will advise the community of its opening.
Again, thank you to Marty O’Neil, Level Plumbing Tamworth, along with the Roejen team. More importantly, we thank the community for your patience and understanding while these works are being undertaken to bring back this long-awaited community facility.
Images - Passive Pool
Active Pool
Program Pool
Published: Friday, 07 November 2025 16:35
Project Update - Moree Artesian Aquatic Centre (MAAC)

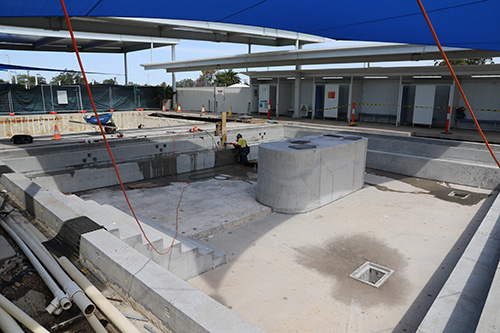

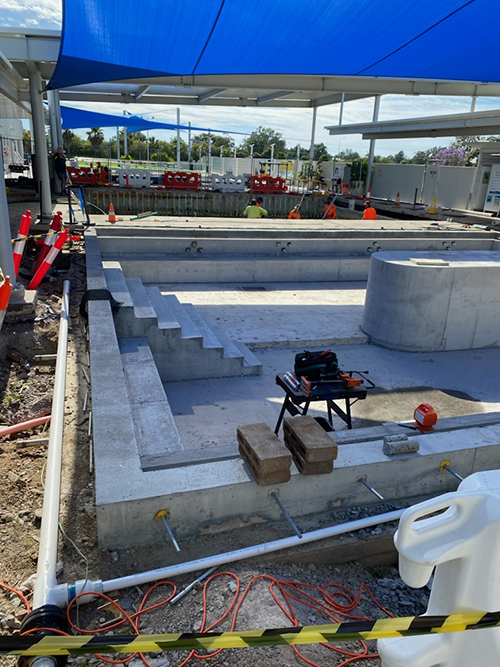

We’re excited to share some great progress on the long-awaited redevelopment of the Moree Artesian Aquatic Centre. Passive Pool A brand-new project team is now on site and specialist local and regional contractors have been engaged to complete the Passive Pool works. A huge thanks to Crawford Constructions for clearing 18 truckloads of rubble and setting the stage for the next big milestone, a new concrete pour by Marty O’Neil and his team next week. Active Pool Work is also moving ahead on the Active Pool. Level Plumbing Tamworth has completed the replacement of the steel pipes with durable, fit-for-purpose poly piping and is connecting all the new plumbing for both pools in line with design specifications. A special thank you to our project team, David and Mark, for keeping everything on track, safely, efficiently and on budget. After years of waiting, it’s great to see this project gaining strong momentum.
Stay tuned for more updates as we bring this long-awaited community facility closer to completion.
Published: Wednesday, 22 October 2025 17:17
Project Update - Moree Artesian Aquatic Centre (MAAC) - October
Work is progressing well at the Moree Artesian Aquatic Centre (MAAC) as part of the ongoing upgrade program. Around 70 tonnes of concrete have already been removed from the Passive Pool, marking another major milestone in the project.

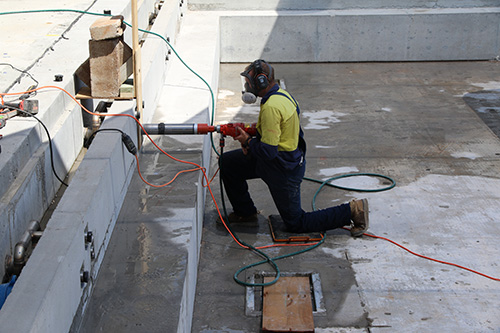

The safe removal of a small section of external asbestos at the clubhouse has been completed, and further work on the reinstatement of the cantilever beam and removal of temporary post support over the change rooms is underway to ensure public safety.

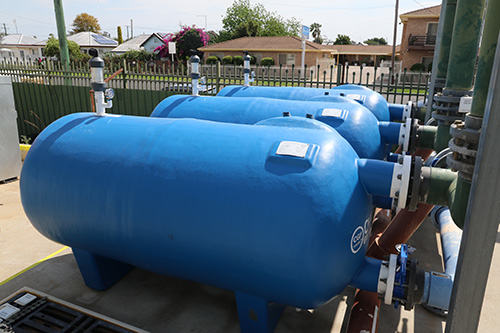

We’re also pleased to share that new filtration pumps, an important part of keeping the pools running smoothly, have been delivered and installed. This upgrade, representing an investment of almost $100,000, will allow us to drain, clean and recommission the Program Pool. Once that process is complete, the waterslide will return to operation.
The Program Pool is expected to reopen by the end of November, and we are excited to be getting closer to welcoming everyone back.
A huge thank you to the community for your patience and understanding as we continue these important works to restore the MAAC experience for everyone.
Images - General Manager Natalia Cowley, Mayor Cr Susannah Pearse, Deputy Mayor Wayne Tighe, with Project Manager David Mangelsdorf. New filtration pumps.

Reinstatement of the cantilever beam. Active Pool with durable, fit-for-purpose poly piping.

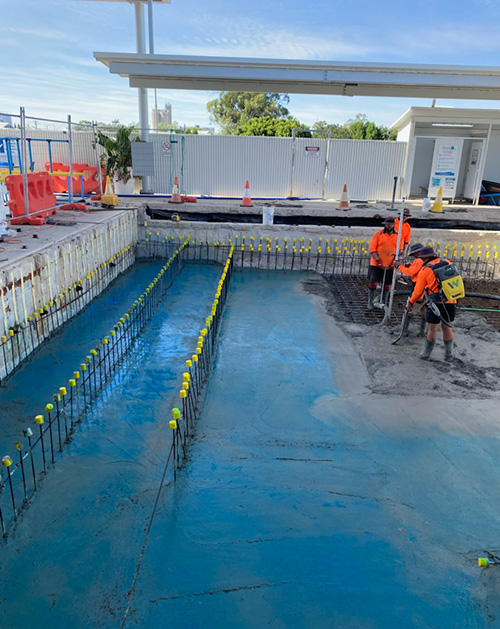

Active Pool is being fitted with durable, fit-for-purpose poly piping. Overview of the Pools
Published: Tuesday, 19 August 2025 16:19
Service Interruption at The Moree Artesian Aquatic Centre (MAAC)
We wish to advise that due to significant faults on two existing sand filters servicing the Program Pool at the MAAC, the Program Pool will be inoperative for approximately 12-14 weeks.
The filters have been assessed, and it has been determined that new filters will need to be ordered and built off-site before being delivered back to Moree.
We understand the inconvenience caused to users of the Centre, and we appreciate the community's understanding as we work towards re-opening the Program Pool as soon as possible.
We will continue to keep the community informed on this matter.
Published: Thursday, 31 July 2025 13:39
Recording - Community briefing and Q&A on 50-Metre Pool
Council held an online briefing session for the community on Wednesday, 30 July 2025, via Microsoft Teams. A recording of the briefing is available below.
Published: Friday, 18 July 2025 16:50
Update: Moree Artesian Aquatic Centre - Program Pool
Assessment of the Program Pool filters at the MAAC has revealed faults in the two existing sand filters, including broken seals, laterals and underdrains due to their age and condition.
These faults have caused sand to discharge into the pipework, pool jets, and the pool itself. The sand also caused damage to the heat exchangers and the heating boost pump.
To address this, the program pool needs to be emptied of approximately 118,00 litres of water and the sand removed by vacuum.
The filtration lines will then need to be continually flushed until all of the sand has been removed from the system.
To minimise the time that the program pool is closed, Council is investigating the options of both repairing and replacing the damaged filters.
Noting that suppliers have advised Council that the replacement sand filters currently have a lead time of 12–16 weeks from the date of order.
We thank everyone for their patience, and we are sorry for the inconvenience. We are doing our best to minimise community impact. Unfortunately, this isn’t a simple or quick issue to resolve, and we will provide the community with updates as soon as we have more information.
Published: Friday, 18 July 2025 11:36
Progress Update: Moree Aquatic Centre
At the July Council meeting, held on 17 July 2025, a resolution was passed that Moree Plains Shire Council proceed with Taylor Oval as the planned site for the new Moree Aquatic Centre.
During the meeting, a report from NSW Public Works regarding Site Feasibility for Taylor Oval was presented to Council.
The report confirmed, “Taylor Oval is a suitable location for the proposed new pool given its connectivity to the town centre, its proximity to the existing sporting and community infrastructure and the local schools.”
Moree Plains Shire Council Mayor, Cr Susannah Pearse, said the study was a step in the right direction, one that allowed Council to continue with existing plans for Taylor Oval as the site for the new pool.
“This study concluded that Taylor Oval is a suitable and feasible location for our new swimming pool, which is really positive,” said Cr Pearse.
“Council is aware of how passionate our community is about our pool and how important it is to have somewhere to swim – especially for children who are learning this vital life skill – so we are pleased to have a number of scenarios to ensure Taylor Oval moves forward as the site.
“In terms of next steps to getting final approval for Taylor Oval as the site for our new pool, the report from NSW Public Works recommended Council consult Heritage NSW and we will proceed based on that recommendation.”
In considering the matter, Council noted the extensive work undertaken in reviewing the site’s cultural heritage – which resulted in the state-approved rezoning more than a decade ago – and has requested that Heritage NSW consider that prior work in a review of the current registration.
If Heritage NSW approves Council's request, next steps will be to undertake additional engineering investigations and consider concept options for design of the new pool.
Images - Taylor Oval, Moree.
Published: Friday, 21 February 2025 16:30
Council Announces Strategic Shift for 50m Pool
Moree Plains Shire Council has undertaken a strategic review of the Moree Artesian Aquatic Centre (MAAC) redevelopment, ultimately identifying that it is time for a new home for Moree’s 50m pool.
“We are deeply sorry for the length of time it is taking to deliver the 50m pool at the MAAC,” said Mayor, Cr Susannah Pearse.
“We know the community is beyond frustrated.
“Council has taken its obligations to the community seriously, to not only deliver necessary community infrastructure, but also set the region up for long term growth and liveability.
“We have considered the challenges faced at the current site over many years, weighed up the options, and in turn, agreed that it is time to let common sense prevail and look at a new site - one which has also been talked about in the community for some time.”
As such, Council resolved at the Ordinary Council Meeting 20 February 2025 to halt works on the current 50m MAAC site and proceed with a feasibility study for Taylor Oval.
“This decision reflects the Council’s consideration of key factors such as providing high quality and value for ratepayer money infrastructure, driving CBD activation, fostering tourism and economic development, supporting future population growth, and addressing the current needs of our residents.
“While changing course may be challenging, it is a necessary step to ensure the long-term viability and sustainability of this vital community asset,” said Cr Pearse.
In its deliberations, Council also considered the future of the MAAC, noting its historic significance and value to the tourism industry. Cr Pearse reassured the community that “Council is committed to planned improvement works to the hot artesian pools at the MAAC”.
“As part of our review, Council will be exploring the best options to keep the important tourist attraction and significant community asset open.”
Cr Pearse applauded the recently appointed Council in strategically tackling the big issues early on, remarking that “this was not an easy call for the council to make. But it is the right call.”
Image - Mayor Susannah Pearse and Deputy Mayor Wayne Tighe are on site at the MAAC where the 50m pool once resided.
Published: Friday, 31 January 2025 17:40
Moree Artesian Aquatic Centre (MAAC) to Reopen on Saturday, 1 February 2025
We are pleased to announce that following essential upgrades and repairs at the Moree Artesian Aquatic Centre (MAAC) the program and wellness pools will reopen tomorrow, Saturday, 1 February 2025, at normal hours from 8am to 6pm. The reopening follows a closure beginning Tuesday, 7 January 2025, due to a failure in aging equipment in the plant room.
General Manager Natalia Cowley expressed her gratitude to the local contractors, businesses and other suppliers involved in this essential maintenance project. "I would like to thank the contractors and businesses who worked diligently to ensure the successful completion of this important upgrade," she said. "We also want to thank the community for their understanding and patience throughout the closure, and we are excited to welcome everyone back to the pools."
The closure allowed for the installation of new chemical tanks, a chemical dosing recirculation system, dosing pumps, and upgraded pipe work, fittings and valves. SafeWork NSW has also lifted the prohibition notices, confirming the upgrades meet all necessary safety requirements.
The completion of these upgrades ensures the safety of staff and visitors and we look forward to welcoming everyone back to enjoy the MAAC.
Published: Tuesday, 21 January 2025 14:41
Moree Artesian Aquatic Centre (MAAC) Update; Re-opening of the Pools
Following the closure of the pools at the Moree Artesian Aquatic Centre (MAAC) on Tuesday 8 January 2025, we would like to update the community on replacing the failed equipment. The chlorine tanks were delivered last week and the installation completed.
Four new chlorine pumps and piping have also been purchased, however, due to transport logistics delays, unfortunately the materials that Council anticipated to arrive last week will now be delivered this week. This delay has impacted the timeline for the full reopening of the facility.
We are now working towards the re-opening of the aquatic side of the MAAC after the Australia Day long weekend.
Acting General Manager Darryl Fitzgerald expressed his appreciation of the endeavours by council staff and local contractors and businesses to reopen the pools. “We acknowledged the community's understanding as we work diligently with SafeWork NSW to have the Centre up and running as soon as possible.”
Access to the gym and café continues to remain available.
Published: Tuesday, 14 January 2025 14:54
Moree Artesian Aquatic Centre (MAAC) Temporary Closure Update
Following the unexpected closure of the Moree Artesian Aquatic Centre (MAAC) on Tuesday, 8 January, due to a prohibition order issued by SafeWork NSW, we are working on reopening the facility in the week commencing 20 January 2025.
Council has been working closely with SafeWork NSW to ensure the ongoing operation of the MAAC, despite challenges posed by aging equipment. Unfortunately, the equipment reached the end of its life before we could complete the planned redevelopment of the new plant room.
We are pleased to announce that we have secured the services of Colonial Chemical to assist with the installation of the tank fit-out, pipework, and temperature system.
We apologise for the inconvenience caused to our valued patrons. Please know that in the interest of public safety, we must comply with the improvement notice. We are doing everything possible to reopen the pools as soon as we can. Access to the gym and cafe will remain available.
Image – The Moree Artesian Aquatic Centre (MAAC) entrance.
Published: Saturday, 07 December 2024 15:07
Pool entry at the Moree Artesian Aquatic Centre (MAAC)
Council resolved at its Standing Committee Meeting, Thursday 5 December 2024 to amend the fees and charges for pool entry at the Moree Artesian Aquatic Centre (MAAC) back to those set out in the 2024/25 Operational Plan and Budget.
This change to the fees will commence on Monday, 9 December 2024.
Per Section 610F (3) and 705 of the Local Government Act 1993, Council discounted the swim entry fee to the MAAC to a casual entry fee of $2.00 per person in August 2024, to encourage attendance while we were unable to offer a fully functioning complex to our users.
Security is and remains an important part of our facility for patrons and staff. However, due to the ongoing need for security and this added and unbudgeted cost to Council, continuing with a discounted fee at the pool is no longer feasible.
Council and Belgravia do not condone violence and anti-social behaviour in any of our facilities and ask the community to be respectful of each other and our staff.
While the complex has encountered challenges, we continue to work towards delivering this project back to the community.
Published: Thursday, 18 July 2024 10:15
Annual Pool Close Down at the Moree Artesian Aquatic Centre (MAAC)
We would like to advise that the annual pool closure at the Moree Artesian Aquatic Centre (MAAC) will take place from 29 to 31 July 2024.
The annual shut down will allow Belgravia Leisure to complete regulated works before reopening on 1 August.
Parallel to the regulated works being completed, Council continues to work on remediation/upgrades within the Centre to the passive and active artesian pool(s).
Upon reopening in August, the passive pool will be closed for refurbishment and shortly thereafter the wellness pool will come online as the public artesian pool, offering Patrons an alternate artesian experience.
Unfortunately, there will be a short period where no artesian pools are available, while this changeover occurs.
From 1 August 2024 entry to the pool will be charged a $2 for all aquatic users (excluding the waterslide and aqua programs).
These changes will not affect the Aqua Movers’ program as this will continue to be facilitated in the program pool.
Once the wellness pool opens, due to its size, there will be a 30 patron limit at any one time. To address capacity issues, we will be running one hour booking slots for patrons who wish to soak in the artesian water.
To help facilitate this, bookings can be made with Belgravia Leisure on (02) 6752 2272.
During this time, we cannot take group bookings for the wellness pool.
The changes at the MAAC will bring into effect:
$2.00 entry fee for everyone over 5 years of age (excluding aquatic programs, gym/fitness and slide fees).
During the redevelopment of our outdoor artesian pools all Aquatic Memberships will be on hold.
30 patron and one hour session limit in the wellness pool.
We encourage all patrons to call and make bookings for the wellness pool, to avoid disappointment.
The MAAC will recommence under the same operational times of Monday to Friday 6am to 7pm and Saturday and Sunday 8am to 6pm.
General Manager Kelvin Tytherleigh acknowledged “that the continual works do see interruptions and we understand that the Centre not running at full capacity, therefore, we have reduced the pool(s) entry fee to a flat $2.00. Council appreciates the community’s understanding as we continue to work on the redevelopment of the MAAC”.
Published: Thursday, 16 May 2024 18:19
A Splashtacular Win for the Moree Artesian Aquatic Centre (MAAC)
Council is pleased to have received acknowledgement of having successfully obtained grant funding of $9,641,761 under Round 1 of the Australian Government Growing Regions Program.
The grant success now ensures works on the multimillion-dollar project can continue with a limited burden to our ratepayers in delivering the capital works, consisting of a new 50-metre pool, children’s play area, grandstand and clubhouse at the Moree Artesian Aquatic Centre (MAAC).
Mayor Mark Johnson excitedly acknowledged his gratitude to the Federal Government and in particular Minister of Infrastructure Catherine King stating, “This announcement is a game changer, we have been working hard to deliver this project and to receive this significant amount of funding, we can confidently work on the continuation of the project”.
Next week, earthworks will commence on the decommissioned location of the previous 50-metre pool.
Moree Plains Shire Council was one of 40 successful applicants to receive funding from the Growing Regions Program. This Program aids in delivering community and economic infrastructure projects across regional and rural Australia.
Published: Tuesday, 06 February 2024 18:25
Moree Artesian Aquatic Centre (MAAC) - Update 1
As works continue to progress on the redevelopment at the Moree Artesian Aquatic Centre, this week, work will commence to prepare the site for the 50-metre pool, with the clearing of the vegetation.
Following on from that, Council has engaged a major local company to commence the earthworks to further prepare and stabilise the site.
The next stage in the site stabilisation will be laying the pier foundation in an area of 50m x 25m, where 180 piers/piles will be drilled into the ground up to 13-metres deep.
These foundation works are critical to the stabilisation of where the 50-metre pool will ultimately sit.
What has been occurring.
Gym
Gym users have stepped into a new era of fitness with new equipment and 15mm rubber impact flooring tiles. (As seen in the image right)
Active Pool

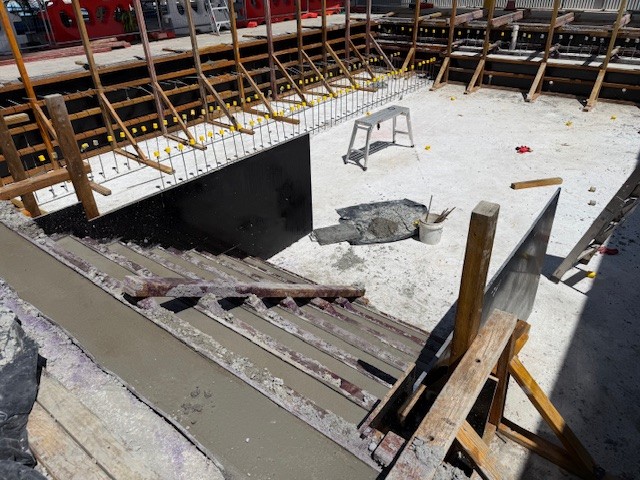

The Active Pool has had the concrete poured, each pour needing 6 weeks to cure. Alongside of the concrete pouring has been the commencement on the pool wall and scum gutter/wet area.
Wellness Pool
The form work has been installed for a concrete pour that will form the walls in the Wellness Pool. (As seen in the image below)
Wellness Studio
Expression of interest in the wellness treatment spaces for wellness and allied health professionals, such as Massage Therapists, Beauty Therapists, Physiotherapists, Osteopaths, and Myotherapists to occupy the rooms at the Wellness Facility are welcomed. Expressions of Interest should be sent via email to This email address is being protected from spambots. You need JavaScript enabled to view it.
“It was fantastic to see so many utilising the pools and waterslide on Australia Day, with 144 people enjoying the free entry offered between 1pm to 3pm”, informed General Manager, Kelvin Tytherleigh.
Published: Friday, 15 December 2023 17:27
MAAC Project Set to Go Full Steam Ahead in 2024
Moree Plains Shire Council continues to progress works on the Moree Artesian Aquatic Centre redevelopment, with Council closing out the year by signing off on the final tender for Stage 1A of the project.
At its Ordinary Council Meeting on 14 December 2023, Moree Plains Shire Council accepted a lump sum tender from Hennessy Construction & Demolitions Pty Ltd to construct the grandstand, clubhouse and concourse.
"We are so pleased to be closing out the year having approved contractors for all key project works at the MAAC," said Acting Mayor, Cr Susannah Pearse.
"Council is just as keen as our community to see the 50m pool and grandstand project delivered soon and delivered well, and approval of this tender is the final formal step before works commence in earnest in early 2024."
Cr Pearse acknowledged the frustration with how long the project has taken to get off the ground, but noted the substantial progress made, "In our Council term, we have gone from there being no funding for this multimillion-dollar project, to having secured over $8m in grant funding for the project, all of which has come from the NSW Government."
"We are keen to limit burden on our ratepayers for this sizeable project, and as such Council also has a $9m funding application under the Australian Government's Growing Regions Program underway, which has pleasingly progressed to the second stage of the program."
Cr Pearse explained that many of the hold ups with the project have been due to faults in much of the infrastructure, "There were substantial issues with much of the MAAC complex, including leaks in the other pools and splash play area which were seeping into the 50m pool cavity. These had to be rectified before works on the 50m could occur".
To date, Council has completed:
redevelopment and reopening of the slide;
addressed leaking program pool through relining;
addressed leaking active & wellness centre pools by decommissioning of the existing structures and renewing plumbing, with new concrete to be poured early 2024;
refurbished function area and amenities.
Stage 1A of the redevelopment project (as per the site plan) includes:
50m Olympic standard 8-lane concrete pool (tender awarded to Crystal Pools Pty Ltd October 2023);
concreted tiered undercover grandstand seating to be located on the southern side of the 50m pool;
construction of new clubhouse and amenities to be located on the western side of the 50m pool and adjacent to the existing clubhouse;
chemical storage and plant room; and
works to the concourse.
Stage 1A is set to commence in early 2024, starting with preliminary earthworks.
Additional stage 2 and 3 works Council is progressing funding applications for include: Stage 2:
Passive pools upgrades.
Stage 3:
Structural revisions and building alterations to existing buildings;
Construction of the combined leisure, learn to swim and toddlers’ pool, with assorted water features;
Upgrade of splash pad and features;
Construction of concourses.
Council's General Manager Mr Kelvin Tytherleigh remarked, "Since joining Council as General Manager 6 months ago, the MAAC has been the number one issue that community has raised with me time and time again. It is clear that there is no more important project to this community, and I am not only proud of the work that our team has completed to date, but excited for what's to come."
"This project when fully completed will not only see the MAAC fully restored, but a bigger and better, quality regional facility for our Shire."
Image - Moree Artesian Aquatic Centre Architectural Perspective 50m pool
Published: Tuesday, 07 November 2023 14:37
Moree Artesian Aquatic Centre - Expression of Interest - Wellness Centre
Expression of interest in the wellness treatment spaces at the Moree Artesian Aquatic Centre is now open.
The Moree Artesian Aquatic Centre are looking for wellness and allied health professionals, such as Massage Therapists, Beauty Therapists, Physiotherapists, Osteopaths, and Myotherapists to occupy the rooms at the Wellness Facility.
Expressions of Interest should be sent via email to This email address is being protected from spambots. You need JavaScript enabled to view it. by 17 November 2023.
Published: Thursday, 12 October 2023 11:14
Tender Awarded For The Construction Of A 50-metre Pool At The Moree Artesian Aquatic Centre
Council resolved at its Extraordinary Council Meeting this morning, Thursday 12 October 2023 to award the tender for the construction of the 50-metre pool at the Moree Artesian Aquatic Centre (MAAC) to Crystal Pools Pty Limited.
Crystal Pools Pty Ltd is a leading Australian commercial pool builder, owned and operated since 1957. Having been in the business for over 65 years, they are certified for Federal, State and Local Government commercial swimming pool design and construction, making them familiar with regulations and requirements.
“My fellow Councillors and I are very excited to have secured a reputable company to complete the 50-metre pool for the community and our visitors, as we are all aware the artesian water brings tourism to our Shire. To have the centre completed with its cold-water pool will help us reinstate us as the ‘Artesian Capital’. We understand the frustration this process has caused in the community, however, we needed to ensure our due diligence was done regarding this project. The awarding of the tender today marks a significant step forward to returning this iconic asset to our Shire" stated Mayor Mark Johnson.
As we continue to keep the community connected to the project, below is the current timeline for redevelopment works at the MAAC.
Current/October 2023 - All pools at the MAAC are currently closed. Belgravia Leisure remains operating the centre to allow customers access to the gym and café and to assist patrons with any enquiries from 6am to 7pm. - Tenders for the club house and grandstand are open for a further two weeks, closing 31 October.
November 2023 - 6 November - The Program and Passive Pools will re-open. - The ‘Learn to Swim’ Program will recommence. - Les Mills Virtual Program will be introduced at the gym, these virtual programs will add to group exercise in cinematic-quality classes from some of the world’s best instructors. - New additions and refreshed painting to the function area
December 2023 - Mid- December - Re-opening of the Wellness Centre. - Waterslide Summer hours recommence, 3pm to 6pm.
January 2024 - Mid-January - Active Pool reopening - 15 January - Gym flooring and equipment upgrades to commence - Mid- January - Earthworks to commence bulk excavation where the previous 50-metre pool was, with piling and back filling.
April 2024 - Construction of the 50-metre pool will commence, with a build time of approximately 15 months.
To enrol in the ‘Learn to Swim’ program or the ‘Les Mills Virtual’ program book online Any enquiries regarding the current construction and pool closure should be directed to council by emailing: This email address is being protected from spambots. You need JavaScript enabled to view it. or phoning (02) 6757 3222.
Published: Monday, 09 October 2023 13:12
Moree Artesian Aquatic Centre Update
Essential works progress at the Moree Artesian Aquatic Centre (MAAC) with the relining of the Program Pool well underway.
After draining the Program Pool, demolition commenced on removing the existing pool liner and existing scum gutter tiles.
To prepare to lay the new liner, surfaces have been grinded back to remove any rough or irregular surfaces.
This week the installation of a new stainless steel scum gutter, and stainless steel handrails continue to be polished ready for the new liner to be installed.
Closure of the pools at Moree Artesian Aquatic Centre (MAAC) will continue while we deliver these fundamental upgrades. During the closure of the pools, Belgravia Leisure will remain open, allowing customers access to the gym and café and assisting patrons with any enquiries from 6am to 7pm.
Council will hold an extraordinary meeting at the Council Chambers, Thursday 12 October to resolve the tender evaluations for the development of the 50m pool at the complex.
Any enquiries regarding the current construction and pool closure should be directed to council by emailing: This email address is being protected from spambots. You need JavaScript enabled to view it. or phoning (02) 6757 3222.
Published: Monday, 09 October 2023 09:57
Extraordinary Council Meeting
There will be an Extraordinary Council Meeting held in the Council Chambers, Level 1, Max Centre, Moree from 8.30am on Thursday 12 October 2023.
Council can call an Extraordinary Meeting to discuss or decide upon an urgent matter that is time sensitive.
In this instance, Council will discussing tender evaluations for the Moree Artesian Aquatic Centre (MAAC).
Published: Monday, 18 September 2023 09:24
Aquatic memberships on hold while we close for essential upgrades at the Moree Artesian Aquatic Centre (MAAC)
Aquatic members will have their memberships placed on hold while we close to undertake essential works at the Moree Artesian Aquatic Centre (MAAC) from Tuesday 3 October 2023 for five weeks.
While the tender evaluation for the 50-metre pool reconstruction process continues, Council has secured a contractor to complete fundamental upgrades on the Passive and Program pool(s). Works to be undertaken include a full relining of the Program Pool, tile maintenance on the Passive Pool and continued works on the Active and Wellness Pools.
“While we are understanding of the disruption this causes to pool users, it is necessary that we undertake a full relining of the Program Pool, which is required every ten to fifteen years to ensure of its continued operation” stated General Manager, Kelvin Tytherleigh.
During the closure of the pools, Belgravia Leisure will remain open allowing customers access to the gym and café and assist patrons with any enquiries from 6am to 7pm.
What changes you can expect to see. October - Belgravia Leisure is adding new healthy additions to their menu in October, including a catering menu for internal and external functions. - In mid-October the Les Mills Virtual Program will be introduced, these virtual programs will add to group exercise in cinematic-quality classes from some of the world’s best instructors. November The Learn to Swim Program will recommence – 6 November 2023 December Re-opening of the Wellness Centre in mid-December 2023 January 2024 Active Pool reopening mid-January 2024 Gym flooring and equipment upgrades – commences 15 January 2024
We anticipate resuming pool operations at the MAAC from 6am Monday 6 November 2023.
Any enquiries regarding the current construction and pool closure should be directed to council by emailing: This email address is being protected from spambots. You need JavaScript enabled to view it. or phoning (02) 6757 3222.
Published: Monday, 28 August 2023 17:27
Tenders for the Moree Artesian Aquatic Centre (MAAC)
Recent tenders for the construction of a 50m pool, clubhouse and grandstand at the MAAC have now closed.
Council received two tenders, which are being assessed.
Published: Tuesday, 01 August 2023 17:28
A Short Closure of The Moree Artesian Aquatic Centre (MAAC) Pools
Council would like to inform the community that due to urgent maintenance works all pools at the Moree Artesian Aquatic Centre (MAAC) will close on Tuesday 8 August for 4 days as Council has secured a contractor to complete these essential works.
While we understand that this is short notice, we expect operations to resume at the MAAC from 8am, Saturday 12 August, allowing patrons access once again to the Passive and Program Pools at the Centre.
Acting General Manager, Nick Tobin stated “We understand that this closure may cause inconvenience and disruption to patrons plans while we undertake repairs to the liner in the Program Pool and tile maintenance on the Passive Pool.
During the closure, the reception at the MAAC will remain open allowing Belgravia Leisure to operate the gym and café, and assist patrons with any enquiries from 6am to 7pm.
I would like to advise that Council has already gone out to selective tender for the clubhouse, 50m pool and grandstand, with applications closing on 14 August 2023.
As contractors become available, progression continues on the Active and Wellness Pool with the newly laid re-enforcement in place, with concreting to commence in the Wellness Pool, while the Active Pool is at the stage of having plumbing works tested”, said Mr Tobin.
We apologise to users of the MAAC for this brief closure, however, it is necessary for the outcome of a larger scope of work to be conducted for the MAAC redevelopment.
Council remains committed to the MAAC redevelopment with $16,668,389 in budget, including $6,735,270 secured in NSW State Government funding.
Published: Monday, 05 June 2023 13:45
Moree Artesian Aquatic Centre (MAAC) Update
Reconstruction works continue at the MAAC, although slowly due to unforeseen delays and hidden additional works.
What have we been doing?
- The myrtha skin/panelling which had been used as a waterproofing membrane within the existing pools has now been completely removed from the wellness and active pools, allowing us to bring the pools back to their bare bones. - A complete reinforced concrete structure will replace the myrtha structure. - All existing plumbing and electrical services will be retested and replaced if required. - Pour concrete flooring – fully reinforced and form up for the new seats and scum gutter (pool grate). The wet deck system will be implemented to aid with the filtration of the pools. - The removal of the kids splash pad area and replaced with astro turf. - We are aiming to have the active pool completed in August.
Where to next?
- Council has been proactively looking for specialised pool builders. - Council has reached out to individual pool builders to ascertain interest in responding to a tender for the reconstruction of the 50m pool. - Tenders are to be called this week with an August closing date for construction of the new 50m pool.
Published: Friday, 21 April 2023 16:44
Splashtacular School Holidays
We’ve heard your feedback!
With the return of the popular waterslide at the Moree Artesian Aquatic Centre (MAAC), slide users can now enjoy the newly restored slide, with the entry fee included in the pool entry price until 1 July 2023.
The slide will be operational on the following days and times.
During school holidays
Everyday 12pm to 4pm
After school holidays
Tuesday, Wednesday and Thursday 2pm to 5pm (until the end of May 2023)
Height restrictions of 120cm apply to ride the slide.
Pool Complex operational times.
Monday to Friday - 7am - 5.30pm (until 1 May) Saturday and Sunday - 7am to 5.30pm (until 1 May)
Current pool price fees
(Residents and Ratepayers)
Adult - $6 Child - $4 Children under 5 - $Free
(General Admission)
Adult - $8 Child - $5 Children under 5 - $Free
Council appreciates the community’s patience while ongoing works at the MAAC continue.
Tenders called for in November 2022, for the 50m Olympic pool, grandstand, and clubhouse at the Moree Artesian Aquatic Centre (MAAC) were considered at Council’s Ordinary Meeting on 16 March 2023.
Unfortunately, no tender submissions met Council’s requirements, and as such Council will now undertake a select tender approach with experienced pool builders.
Council understands the frustration in the Community regarding the length of time this process is taking but is committed to making sure this is done thoroughly to enable the best outcome.
Council will continue its pursuit to find a reputable and adequately resourced company and we will continue to keep the public informed of the progress.
In the meantime, the works schedule continues at the Moree Artesian Aquatic Centre: • Commencing Tuesday 21 March, the reconstruction and reinstating of the newly refurbished water slide will take place with testing of the slide to be conducted over the next four weeks • Demolition of the wellness and active pool has already commenced and the installation of reinforced steel, formwork and plumbing occurring • Concrete to be poured, with a curating time of six weeks after which the tiling of the pool (and concourse) will occur • Followed by grouting with a wait time of a week until the filling of the pool(s). The active and wellness pool is forecast to be completed in June 2023 • Works on the passive and program pool will commence in June 2023 to coincide with the reopening of the active and wellness pool(s).
Published: Thursday, 02 February 2023 09:33
Moree Artesian Aquatic Centre (MAAC)
Patrons visiting the MAAC will notice a disruption to the ambience at the pools as works take place on the Active and Wellness Pool(s) between the hours of 7am to 5pm, for approximately 3 weeks (weather permitting).
We apologise for the additional noise while we continue to work on the improvements at the MAAC.
Published: Wednesday, 23 November 2022 15:48
$777,778 Cash Splash for Moree Sports and Community Facilities
Popular Moree water slide to be repaired & re-opened
NORTHERN Tablelands MP Adam Marshall has made a giant splash in Moree today – or at least a cash splash – announcing a $777,778 State Government grant for Moree Plains Shire Council to upgrade local sporting and recreational facilities, including re-instating the popular water slide in Moree.
Mr Marshall was joined by Mayor Mark Johnson for the announcement of the funding this morning at the Moree Artesian Aquatic Centre (MAAC), which will receive $350,000 to repair and re-open the mothballed water slide and water slide tower.
“The giant water slide has been out of action for almost two years now due to damage and corrosion of the slide tower, so the news that the slide will be repaired and back in action is really welcome news for the community,” Mr Marshall said.
“The water slide was easily the most popular feature of the MAAC, especially for local youngsters, and council is hoping all the required work can be completed ahead of the Christmas school holidays, which would be brilliant.
“This is just the latest funding for council to improve the MAAC, on the back of just over $6 million provided previously for the new 50-metre pool and associated amenities.”
Mr Marshall said $127,778 would also be spent upgrading the existing canteen, changeroom, storage and toilet facilities at the Ron Harborne Sporting Precinct.
“Ron Harborne is the home of Moree sport with cricket, netball, soccer and athletics just some of the codes utilising the precinct and sharing facilities,” Mr Marshall said.
“Upgrading the shared amenities and kiosk will be a huge boost for all sporting codes and make playing sport even more enjoyable for participants.”
The remaining $300,000 will be used by Council to expand the scope of the $2.4 million upgrade of the Moree Civic Precinct, currently underway, to include a new stage and some audio visual equipment.
“Built in 1923, the Moree Civic Precinct comprises the Memorial Hall, the Banquet Hall and the Moree Community Library,” Mr Marshall said.
“The facility, while grand, lacks the modern facilities required to meet the needs of local theatrical and dance groups, visiting stage shows, schools and community organisations.
This additional funding will be the ‘cherry on top’ for the current upgrade project, allowing council to complete the whole renovations, leaving nothing out.”
Cr Johnson welcomed the funding boost and said it would allow council to undertake the essential upgrades immediately, rather than holding off until sufficient funds were found.
“This is a wonderful bonus that we weren’t budgeting for, especially as we lead into the festive season,” Cr Johnson said.
“Fixing up the water slide will be a big bonus for the younger people in the community and we’re really looking forward to getting it up and running again.
“I’m pleased to say that work on the slide will begin next week, so we can get that operational again as soon as possible.
“A big thank you to the State Government for providing Moree with this funding to allow us to proceed with these longstanding community projects.”
Media Release - Adam Marshall
Member for Northern Tablelands Adam Marshall, left, and Moree Plains Shire Mayor Mark Johnson at the soon-to-be repaired and re-opened Moree water slide today, which is one of the projects sharing in the $777,778 cash windfall today from the State Government.
Moree Plains Shire Council 2024 ABN: 465 667 905 82
